Database Migration Strategies: A Practical Guide to Seamless Transitions
A database migration strategy is the technical plan for moving data from a source system to a target system. A sound strategy is the difference between a controlled, predictable transition and a high-risk project plagued by data loss, extended downtime, and budget overruns.
Why Database Migration Is a Strategic Imperative
Database migration is no longer a tactical IT project; it’s a foundational business decision that directly impacts competitive capability. In an economic environment where data underpins every significant operational and strategic decision, a legacy database is a direct impediment to growth, limiting analytics, AI adoption, and scalability.
Operating on an outdated system is analogous to running a high-speed rail network on 19th-century tracks. The legacy infrastructure cannot support the performance, scale, or architectural flexibility required for modern data workloads, such as real-time analytics or generative AI model training.
From Technical Task to Business Driver
Market data substantiates this shift. The global data migration market is projected to grow from $10.55 billion in 2025 to $30.70 billion by 2034. This growth is a direct result of over 85% of organizations adopting a cloud-first strategy. You can review the full research about these data migration trends for detailed market analysis.
This trend reframes migration from a technical necessity to a strategic enabler that unlocks the latent value in an organization’s data assets.
A well-executed database migration is not merely a technology swap. It is a fundamental re-architecture of the data foundation to support future business objectives, from real-time analytics to generative AI.
Navigating Your Migration Journey
This guide provides a practical, analytical roadmap for technical and business leaders responsible for overseeing a database migration. It bypasses abstract theory in favor of actionable insights applicable at each stage of the process.
The following table outlines the key stages of a structured migration, serving as a high-level project management framework.
Your Database Migration Roadmap at a Glance
| Migration Stage | Key Objective | Critical Decision Point |
|---|---|---|
| 1. Strategy Selection | Define the how. | Choose between Big Bang, Trickle, or a hybrid approach based on risk and downtime tolerance. |
| 2. Planning & Design | Create the detailed blueprint. | Finalize the target architecture, toolset, and resource allocation. |
| 3. Pre-Migration Prep | Prepare the source system. | Cleanse data, perform backups, and establish baseline performance metrics. |
| 4. Execution | Transfer the data. | Execute migration scripts, monitor progress, and manage the cutover process. |
| 5. Validation & Testing | Confirm data integrity and performance. | Verify that data is accurate, complete, and the new system meets performance SLAs. |
| 6. Cutover & Go-Live | Transition production to the new system. | Execute the final switch and redirect user traffic. |
| 7. Post-Migration | Optimize and decommission. | Fine-tune performance, monitor the new environment, and safely retire the legacy system. |
This framework ensures a disciplined approach to a complex undertaking.
Here’s a closer look at what you’ll learn:
- Decision Frameworks: A breakdown of the core migration strategies—“Big Bang” and “Trickle”—and a clear framework for selecting the appropriate approach based on risk tolerance, budget, and downtime constraints.
- Actionable Roadmaps: A detailed seven-phase plan that covers the entire process, from initial assessment to post-migration optimization.
- Risk Mitigation: Proven techniques for executing a near-zero-downtime migration to maintain business continuity for critical applications.
- Platform-Specific Guidance: A focused analysis of migrating to modern cloud data platforms like Snowflake and Databricks to inform platform selection.
Ultimately, selecting the right database migration strategy is about future-proofing an organization’s data architecture, setting the foundation for sustained growth and innovation.

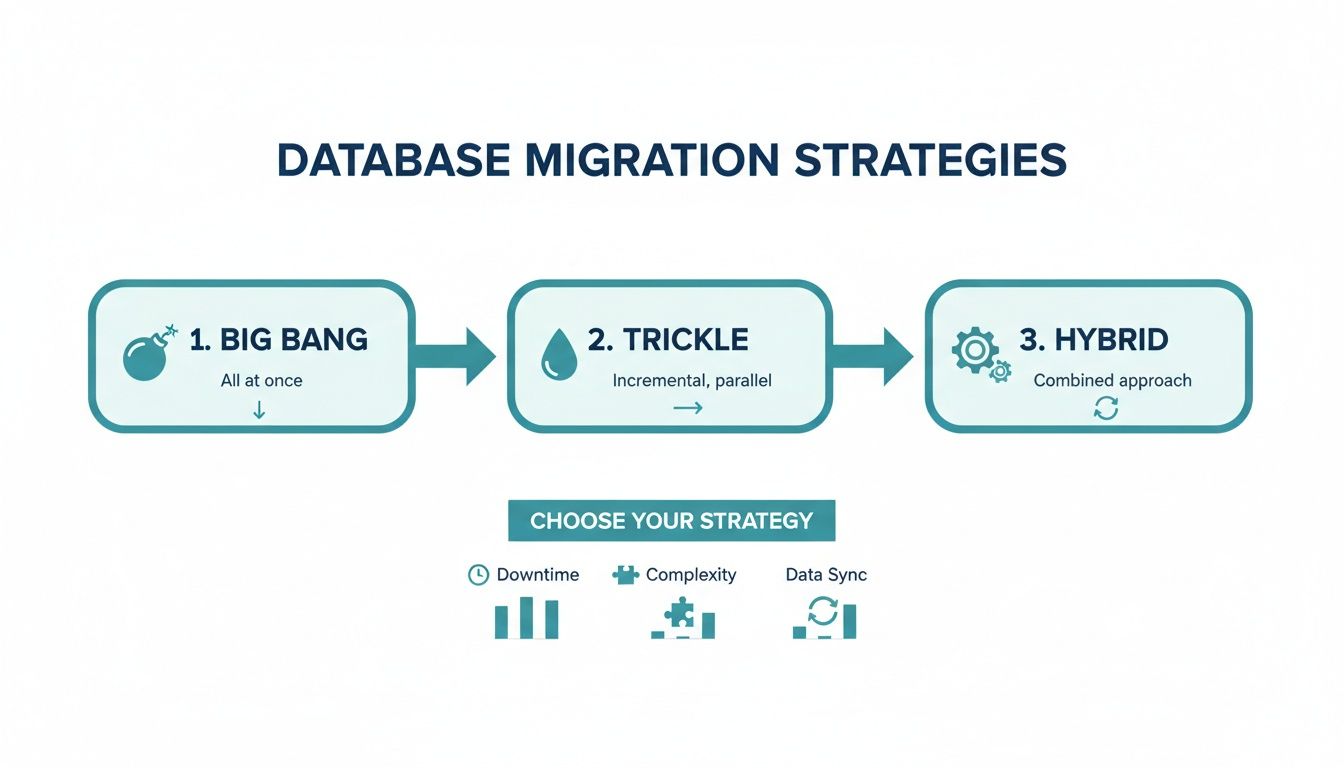

Choosing Your Migration Path: A Decision Framework
The selection of a database migration strategy is a business decision informed by technical constraints. The primary trade-off is between speed and risk. Consider the analogy of relocating a household: one could move everything in a single weekend—a high-risk, high-reward approach—or move one room at a time over several weeks, a slower but safer method. The optimal choice depends entirely on the specific circumstances.
The three primary database migration strategies—Big Bang, Trickle, and Hybrid—are governed by this same logic. Each necessitates a different balance of speed, cost, risk, and operational disruption. The right choice requires an objective assessment of an organization’s tolerance for each factor.
The Big Bang Migration Strategy
The Big Bang approach involves migrating all data from the source to the target system in a single, condensed operation. This typically occurs during a planned maintenance window. The source system is taken offline, data is transferred, and the new system is brought online to replace it.
- When to Use It: This is a viable option for smaller, less complex databases or non-critical applications where a defined period of downtime is acceptable. Internal tools or development environments are common candidates.
- The Upside: The primary advantages are speed and simplicity. The project has a clear endpoint, simplifying project management and reducing the period of operational uncertainty.
- The Downside: The risk is extremely high. Any failure during the migration—from data corruption to performance issues—results in a total system outage. A failed Big Bang migration causes significant business disruption and requires a robust, pre-tested rollback plan, which is difficult to execute under pressure.
The Trickle Migration Strategy
The Trickle migration, also known as a phased or incremental approach, involves moving data in smaller, controlled segments over an extended period. The defining characteristic is that the source and target systems run in parallel. A data synchronization tool, typically leveraging Change Data Capture (CDC), ensures that any modifications to the source data are replicated to the target in near real-time.
A Trickle migration is analogous to renovating a kitchen while continuing to live in the house. It is a slower, more complex process requiring careful coordination, but it avoids major disruption to daily operations. Maintaining perfect synchronization between the two environments is critical.
- When to Use It: This is the standard strategy for mission-critical systems where downtime is unacceptable, such as e-commerce platforms, core financial systems, or large, complex databases where uptime is directly tied to revenue.
- The Upside: Risk is substantially reduced. By migrating in phases, each data segment can be tested and validated independently. Business operations continue without interruption, and users can be transitioned to the new system gradually with little to no perceived downtime.
- The Downside: This method is significantly more complex and costly. Operating two systems in parallel increases infrastructure costs and requires specialized tooling and expertise for data synchronization. The project timeline is also considerably longer.
The Hybrid Migration Strategy
A Hybrid strategy combines elements of both Big Bang and Trickle approaches. For example, a large volume of static, historical data might be moved using a Big Bang approach over a weekend. Subsequently, a Trickle approach would be used to continuously sync active, transactional data up to the final cutover.
This method offers a practical balance, leveraging the speed of a Big Bang for the bulk of the data while using the safer Trickle method for dynamic data, thereby optimizing the risk/reward profile.
Making The Right Choice: A Comparison
An informed decision requires weighing these strategies against specific business needs and technical constraints. There is no universally “best” answer, only the most appropriate one for a given context.
This table provides a direct comparison of the trade-offs.
Comparing Database Migration Strategies
| Strategy | Best For | Downtime Risk | Cost Profile | Implementation Complexity |
|---|---|---|---|---|
| Big Bang | Small datasets, non-critical systems, and applications with low data complexity. | High - Requires a significant planned outage for the entire cutover. | Lower - Shorter timeline and no need for parallel environments. | Low - Simpler to plan and execute with a clear start and end. |
| Trickle | Large, complex databases, mission-critical systems, and zero-downtime requirements. | Low - Allows for gradual cutover with minimal to no user disruption. | Higher - Requires parallel infrastructure and data synchronization tools. | High - Complex to manage two systems and ensure data consistency. |
| Hybrid | Systems with a mix of static historical data and active transactional data. | Medium - Downtime is limited to the initial bulk load, not the final cutover. | Medium - Balances the cost of a full Trickle with the speed of a Big Bang. | Medium - More complex than Big Bang but less so than a full Trickle. |
The final choice must be grounded in operational realities. Our cloud migration assessment checklist can help identify system dependencies and critical requirements before committing to a specific strategy.
Asking the right questions upfront is the most effective way to prevent costly errors.
Once a high-level migration strategy is selected, the detailed execution phase begins. A successful database migration is not a matter of luck but the result of a deliberate, phased process that manages complexity and minimizes unforeseen issues.
This seven-phase roadmap provides a proven project management blueprint for structuring the entire effort, from initial discovery to long-term performance optimization.

This diagram summarizes the core trade-off between speed and risk. A Big Bang migration prioritizes speed at the cost of high risk, while the Trickle approach prioritizes safety through a slower, more deliberate process.
Phase 1: Discovery and Assessment
This is the most critical phase and the one most frequently rushed. Errors made here have cascading effects. The objective is not merely to catalogue databases but to develop a comprehensive understanding of the entire data ecosystem.
Key activities include:
- Data Dependency Mapping: Identify all upstream data sources that feed the database and all downstream applications that consume its data. This includes reports, APIs, and other systems.
- Schema and Query Analysis: Document the existing database schema, data types, and common SQL query patterns. This information is essential for designing the target data model and anticipating performance issues.
- Performance Baselining: Measure and document the current system’s performance metrics, such as query latency and throughput, to establish objective success criteria for the new system.
The deliverable for this phase is a comprehensive assessment report detailing the project scope, critical dependencies, and identified risks.
Phase 2: Strategy and Partner Selection
With the assessment complete, the migration strategy can be finalized, and if necessary, an implementation partner can be selected. Decisions at this stage are data-driven, based on the findings from Phase 1.
For example, if the assessment reveals numerous critical applications with zero downtime tolerance, a Big Bang approach is ruled out. This is also the stage to develop a formal Request for Proposal (RFP) to evaluate potential vendors.
Selecting a partner based on the lowest bid is a common mistake. The right partner has demonstrable experience on the target platform and a methodology aligned with the project’s risk tolerance. Their expertise prevents costly errors that far outweigh initial savings.
Phase 3: Design and Architecture
This phase translates the strategy into a detailed technical design. It involves mapping source schemas to target schemas, designing the data pipeline for data movement, and defining the security architecture.
Key design tasks include:
- Target Schema Design: This is an opportunity to optimize the data model for the new platform, not just a “lift and shift.” This may involve denormalization for a NoSQL database or designing table structures for a cloud data warehouse like Snowflake.
- Tooling Selection: Select the specific ETL/ELT tools, data synchronization software (e.g., Change Data Capture tools for a Trickle migration), and validation scripts that will be used.
- Security and Governance Plan: Define access controls, encryption standards, and data governance policies for the new system from the outset. Security should not be an afterthought.
Phase 4: Pre-Migration Testing
Before migrating any production data, the plan must be rigorously tested. This involves setting up a staging environment that mirrors production and conducting stress tests to identify and resolve issues in a low-risk setting.
This phase must include:
- Tool and Script Testing: Execute all migration scripts and tools to ensure they function as expected.
- Performance Testing: Conduct load testing to verify that the target architecture can handle real-world production workloads and meet the performance baselines established in Phase 1.
- Rollback Plan Rehearsal: Execute the rollback procedure. A rollback plan that has not been tested is not a plan; it is a hypothesis.
Phase 5: Execution and Cutover
This is the core data migration phase. The execution methodology is dictated by the chosen strategy. For a Big Bang, this is a concentrated effort during a planned outage. For a Trickle migration, it is a prolonged, monitored process of data synchronization while both systems run in parallel.
The cutover is the point at which application traffic is redirected from the source database to the target. This requires precise coordination and clear communication across all involved teams.
Phase 6: Validation and Reconciliation
Immediately following the cutover, the primary objective is to validate the migration’s success. This extends beyond simple data presence checks to confirming data integrity and completeness.
The validation checklist should include:
- Row and Object Counts: A basic check to ensure record counts in source and target tables match.
- Data Reconciliation: Use checksums or automated queries to verify that the data itself is identical and has not been corrupted during transfer.
- Application Functional Testing: Involve business users to execute critical workflows and confirm that applications function correctly with the new database.
Phase 7: Post-Migration Optimization
The system is live, but the project is not complete. The final phase involves monitoring the new environment, optimizing performance, and decommissioning the legacy system. This includes fine-tuning queries, adjusting resource allocation based on actual usage, and verifying that backup and disaster recovery processes are fully functional.
Only after a sustained period of stable operation, typically 30 to 90 days, should the legacy database be decommissioned.
Mitigating Risk with Zero-Downtime Migration

For systems that directly support revenue generation, such as e-commerce platforms or SaaS products, downtime translates to direct financial loss. In these contexts, a zero-downtime migration strategy is not an optional luxury but a business requirement. It transforms a high-risk cutover event into a controlled, non-disruptive transition.
The core technology enabling this is Change Data Capture (CDC). CDC acts as a real-time transaction log reader for the source database, capturing every insert, update, and delete as it occurs.
This continuous stream of changes is then applied to the target database, ensuring that while the initial bulk data load is in progress, the two systems remain synchronized. The target database is never stale; it functions as a live replica of the source.
The Power of Parallel Operations
With CDC in place, both the legacy and new systems can operate in parallel. This dual-environment setup serves as the ultimate safety net. It allows for a gradual routing of read-only traffic to the new system, enabling direct performance and data-comparison against the legacy system without impacting live users.
This parallel run phase is about building empirical confidence in the new system. It moves the project from theoretical validation to proving stability and data accuracy with live production workloads. The final cutover occurs only after this verification is complete.
A zero-downtime migration strategy shifts the focus from a single, high-pressure “go-live” event to a gradual, evidence-based process of verification. You cut over only when the data proves the new system is ready, not when the project plan says you should.
The demand for these advanced techniques is accelerating. By 2027, an estimated 90% of enterprises will operate multi-cloud architectures, making seamless data mobility a critical capability. Traditional ‘big bang’ migrations carry unacceptable risks in these complex ecosystems. However, aggressive timelines often lead teams to curtail validation, a shortcut that invariably introduces instability.
Guaranteeing Data Integrity Through Validation
Even with perfect synchronization, data integrity must be proven, not assumed. Subtle data issues can go undetected until they cause significant business problems. Rigorous, automated validation is the only way to ensure a flawless transition.
Essential validation techniques include:
- Automated Reconciliation Queries: Custom scripts that run against both databases to compare data at a granular level. These can verify row counts, sum numerical columns, or perform checksums on data segments to flag discrepancies.
- Data Sampling and Deep Dives: For very large tables where a full comparison is not feasible, random samples of records can be selected for a detailed, field-by-field comparison. This is effective for identifying issues like data type mismatches or character encoding errors.
- Functional Application Testing: Business users must validate that their critical business processes execute correctly on a sandboxed version of the new system. This confirms that the migrated data supports all required application workflows.
These validation strategies are the project’s insurance policy, ensuring the migrated data is a perfect, reliable copy. This diligence also extends to protecting data in transit. For a detailed analysis, refer to our guide on the key cloud data security challenges you may encounter.
By combining real-time synchronization with relentless validation, the project is systematically de-risked, ensuring business continuity throughout the transition.
Snowflake vs. Databricks: Picking the Right Home for Your Data
When modernizing a data stack, the choice of a cloud platform is a long-term strategic decision. The evaluation frequently narrows to two dominant platforms: Snowflake and Databricks.
Beyond marketing claims, the correct choice depends on the primary use case for the data. The answer dictates the entire migration path, including tooling and required team skillsets. This is not a one-size-fits-all decision.
The Great Divide: Warehouse vs. Lakehouse
Snowflake and Databricks are built on different architectural philosophies.
Snowflake is a cloud-native data warehouse, engineered for analyzing structured and semi-structured data. Its architecture, which decouples storage and compute, is highly efficient for business intelligence (BI), SQL-based analytics, and serving data concurrently to many users.
Databricks is a data lakehouse, originating from the Apache Spark project. It unifies data warehousing, data science, and machine learning on a single platform. It handles unstructured data—such as images, audio, and raw text logs—as proficiently as structured tables, making it the preferred platform for advanced AI and machine learning workloads.
A useful analogy: Snowflake is a meticulously organized library, optimized for rapidly finding and analyzing specific information. Databricks is a high-tech workshop, equipped with a vast array of raw materials and advanced tools to build anything from a simple report to a complex AI model.
Match the Platform to Your Mission
Selecting a platform misaligned with primary business objectives will lead to friction, cost overruns, and technical debt. The migration strategy must be driven by the primary use case.
Consider these common scenarios:
- Primary Use Case is Business Intelligence: If the main goal is to power BI dashboards in tools like Tableau or Power BI, Snowflake’s SQL-native environment and automated performance tuning often provide the most direct migration path for traditional data warehouse workloads.
- Primary Use Case is AI and Machine Learning: For teams focused on building predictive models or analyzing real-time IoT data, Databricks is the purpose-built solution. Its integrated notebooks and tools like MLflow create a unified environment for data scientists and ML engineers.
- Data Sharing is a Top Priority: Snowflake’s Data Cloud and secure data sharing capabilities are a key differentiator. If securely sharing governed data with external partners, vendors, or customers is a critical requirement, this feature can be a decisive factor.
- Heavy Reliance on Unstructured Data: For organizations that need to analyze video, audio, or large volumes of text, the Databricks Lakehouse architecture is a more natural and cost-effective solution than attempting to force unstructured data into a traditional warehouse model.
Brace for These Migration Hurdles
Migrating to either platform is a complex undertaking that requires careful planning, especially regarding proprietary features that can create vendor lock-in.
| Migration Challenge | Snowflake Considerations | Databricks Considerations |
|---|---|---|
| Schema & Code Conversion | Migrating from SQL-based systems is generally straightforward. However, proprietary SQL functions and complex stored procedures must be rewritten and extensively tested. | A migration to Databricks often requires re-platforming code to Spark SQL or PySpark. Legacy PL/SQL or T-SQL must be completely rewritten, representing a significant engineering effort. |
| Proprietary Feature Lock-in | Features like Zero-Copy Cloning and Time Travel are powerful but non-standard. Operational workflows built around these features will need to be re-engineered if a future migration is considered. | While Delta Lake is an open format (reducing storage lock-in), platform-specific optimizations and governance tools like Unity Catalog create a strong dependency on the Databricks ecosystem. |
| Cost Model Complexity | The pay-per-second compute model offers flexibility but requires strong governance to prevent cost overruns. Query optimization is essential for managing spend. | The Databricks Unit (DBU) pricing model can be difficult to forecast. Costs are tied to cluster uptime, so disciplined management of idle clusters is critical to control expenses. |
The decision is not about which platform is “better,” but which is the right tool for the specific job. A rigorous, objective assessment of data strategy and use cases is the only way to ensure a successful, on-budget migration that supports future business needs.
Selecting Your Migration Partner: An RFP Checklist
Choosing a migration partner is as critical as selecting the right technology. An experienced partner can accelerate timelines and mitigate risks, while an unqualified one can lead to costly delays or project failure. A structured selection process, anchored by a robust Request for Proposal (RFP), is essential.
An effective RFP should probe beyond pricing to assess a potential partner’s technical capabilities, project methodology, and commercial practices. It serves as a diagnostic tool to differentiate experienced implementation teams from those with less practical experience.
Core RFP Evaluation Criteria
A well-constructed RFP is direct and demands specific, evidence-based responses in these key areas:
- Platform Expertise: Request evidence of certified experts on the target platform (Snowflake or Databricks). Ask for anonymized resumes of the key personnel proposed for the project.
- Methodology and Tooling: Require a detailed explanation of their project management methodology, particularly their process for post-cutover data integrity validation. Inquire about the specific tools they use.
- Industry Experience: Demand case studies from migrations of similar scale and complexity within your industry, including quantifiable results.
- Zero-Downtime Experience: For mission-critical systems, ask for detailed accounts of their experience implementing Change Data Capture (CDC) and other zero-downtime techniques. Hesitation in this area is a significant concern.
- Project Governance: What is their communication and reporting framework? A clear governance plan prevents misalignments and surprises.
- Commercial Transparency: Pricing models and rate cards should be clear and easy to understand. Vague or complex cost structures are a red flag.
- Post-Migration Support: Define the scope of post-go-live support. The initial 30-60 days are critical for stabilization and optimization.
The objective of an RFP is not to find the cheapest vendor, but the one that delivers the highest value with the lowest risk. A low bid from an inexperienced team often becomes the most expensive option in the long run.
Spotting Potential Red Flags
As RFP responses are evaluated, be vigilant for these warning signs:
- Lack of Specific Case Studies: Vague success stories without concrete data suggest a lack of relevant experience.
- Over-Rely on Subcontractors: A team composed primarily of third-party contractors can introduce communication gaps and accountability issues.
- Offer a “One-Size-Fits-All” Approach: A partner who does not ask probing questions about your specific environment is not performing adequate due diligence.
- Cannot Provide Client References: An unwillingness to provide references from past clients is a major red flag.
A disciplined evaluation process is the foundation of a successful project. For further guidance on managing these critical relationships, our guide on vendor management best practices provides a framework for building effective partnerships. A checklist-driven approach enables a decision based on evidence, not salesmanship.
Your Top Database Migration Questions, Answered
These are the practical, frequently asked questions that arise during the planning phase of any serious database migration project.
How Long Is This Really Going to Take?
Project duration is a function of data volume, data quality, system complexity, and the chosen migration strategy. A simple migration of a small, well-structured database might take a few weeks.
However, a multi-terabyte migration from a legacy on-premise system to a cloud platform like Snowflake, especially one involving data model redesign and zero-downtime requirements, should be realistically budgeted for 6 to 12 months or more.
The data transfer itself is often the quickest part of the project. The most time-consuming phases are the initial discovery and assessment, and the final, exhaustive testing and validation.
What Are the Biggest Hidden Costs I’m Not Thinking About?
Beyond software licenses and data transfer fees, several hidden costs can significantly impact the project budget.
The most significant budget overruns in a migration rarely come from the initial estimate. They arise from the consequences of inadequate testing, unexpected performance issues, and the extended operational cost of running parallel systems.
Budget for these potential costs:
- Business Downtime: If a zero-downtime migration encounters problems, the resulting lost revenue can dwarf all other project expenses.
- Endless Testing Cycles: Comprehensive testing is time-intensive, requiring significant man-hours for scripting, execution, and validation. Under-investing in testing leads to post-launch failures.
- Post-Migration Tuning: The project does not end at go-live. Plan for significant resource allocation for performance tuning and query optimization on the new platform during the first few months of operation.
Can We Just Do This In-House?
While technically possible with a strong internal engineering team, attempting a major migration without specialized expertise is often a case of being penny-wise and pound-foolish.
Specialized migration partners possess battle-tested automation tools, deep platform-specific knowledge, and playbooks for navigating common pitfalls. Engaging an expert not only reduces risk but also accelerates the timeline and allows the internal team to remain focused on core business activities.
Finding the right partner is more than half the battle. At DataEngineeringCompanies.com, we cut through the noise with data-driven rankings and practical tools to help you pick a vendor you can trust. Explore our 2025 expert rankings and RFP checklists to streamline your decision-making process.
Top Data Engineering Partners
Vetted experts who can help you implement what you just read.
Related Analysis

A Practical Guide to Streaming Data Platforms
A practical guide to understanding a streaming data platform. Learn core architectures, use cases, and how to choose the right tools for real-time results.

Orchestration in Cloud: A Practical Guide for Modern Data Platforms
Discover how orchestration in cloud streamlines modern data platforms. Learn key concepts, tools, and best practices for scalable, reliable operations.

Snowflake vs Databricks: An Objective Data Platform Comparison
Explore a definitive Snowflake vs Databricks comparison. This guide analyzes architecture, performance, AI/ML use cases, and TCO to inform your data strategy.
